The projects require several intermediate storage areas for cables and accessories

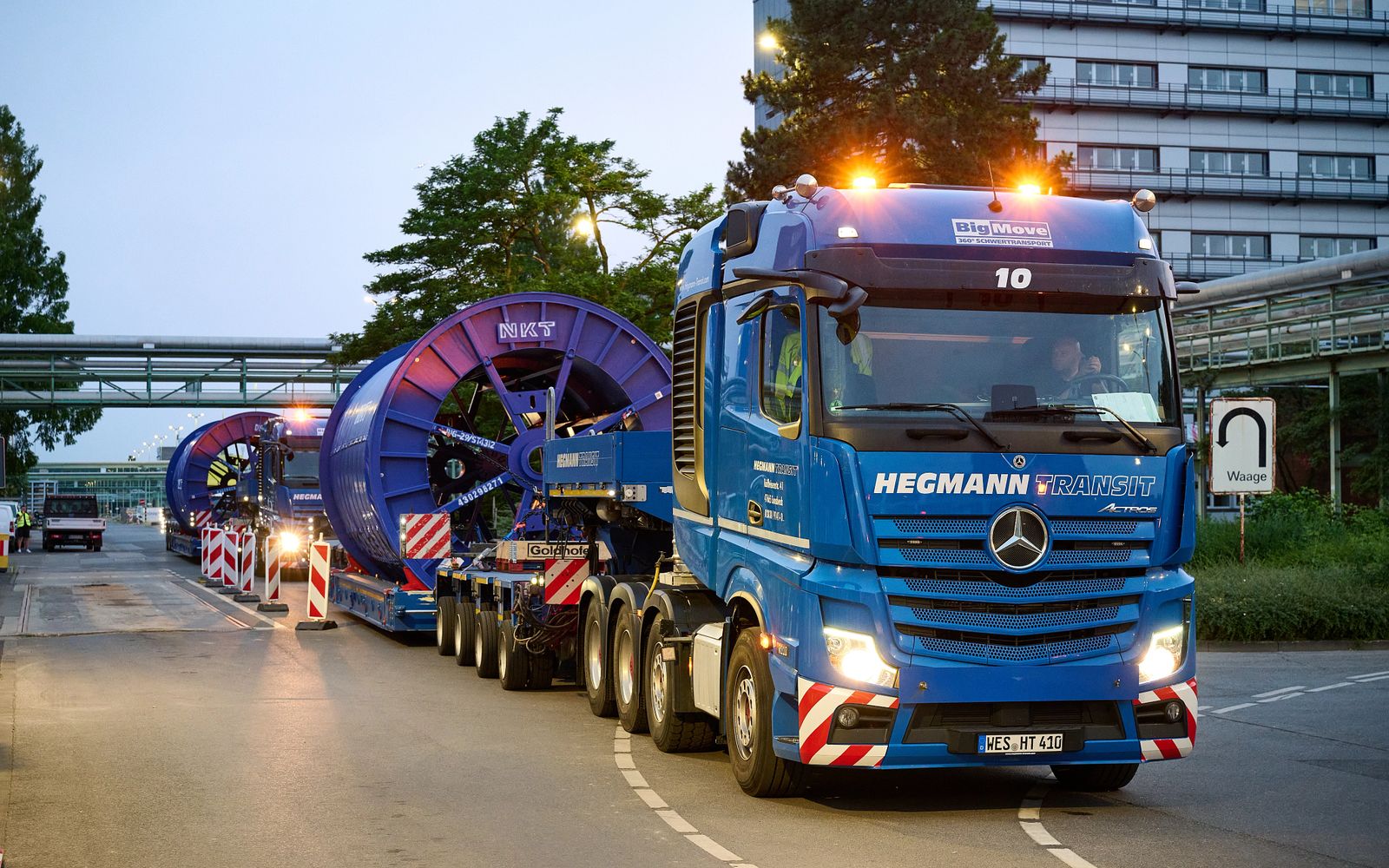

The corridor cables are continuously delivered and will be installed in stages. As NKT supplies from two production sites, the delivery concept is different. The finished cable sections, measuring up to two kilometers in lengths, will travel by ship and heavy-duty low-bed trucks to the cable interim storage facilities. The cable drums are delivered regardless of the progress of construction and are temporarily stored in the ISAs.
Each of the eight (SuedLink) and three (SuedOstLink) storage facilities will supply construction sites within a radius of approximately 50 kilometers. This will allow the heavy-duty low-bed trucks to travel between the storage and construction sites in a single night. Office containers will accommodate the teams responsible for storing, transporting and laying the cables.

Moving more than power cable drums

Listen to Head of Logistics Management Christoph Eising
